Executing a construction contract for a major home remodel is a significant financial step. For our project—a complete down-to-the-studs first-floor remodel and second-story addition—we were signing a base contract valued at $790,000, with total project costs ultimately exceeding $1 million once change orders, materials, and contingency expenses were factored in.

At this scale, we quickly realized that while architectural plans define how your future home will look, the contract defines how your finances and peace of mind are protected. A standard, generic template provided by a builder often favors the contractor. To protect our investment, we worked closely with our construction team to incorporate specific legal protections, milestone-based payments, and post-completion warranties into our primary Home Improvement Contract (HIC).

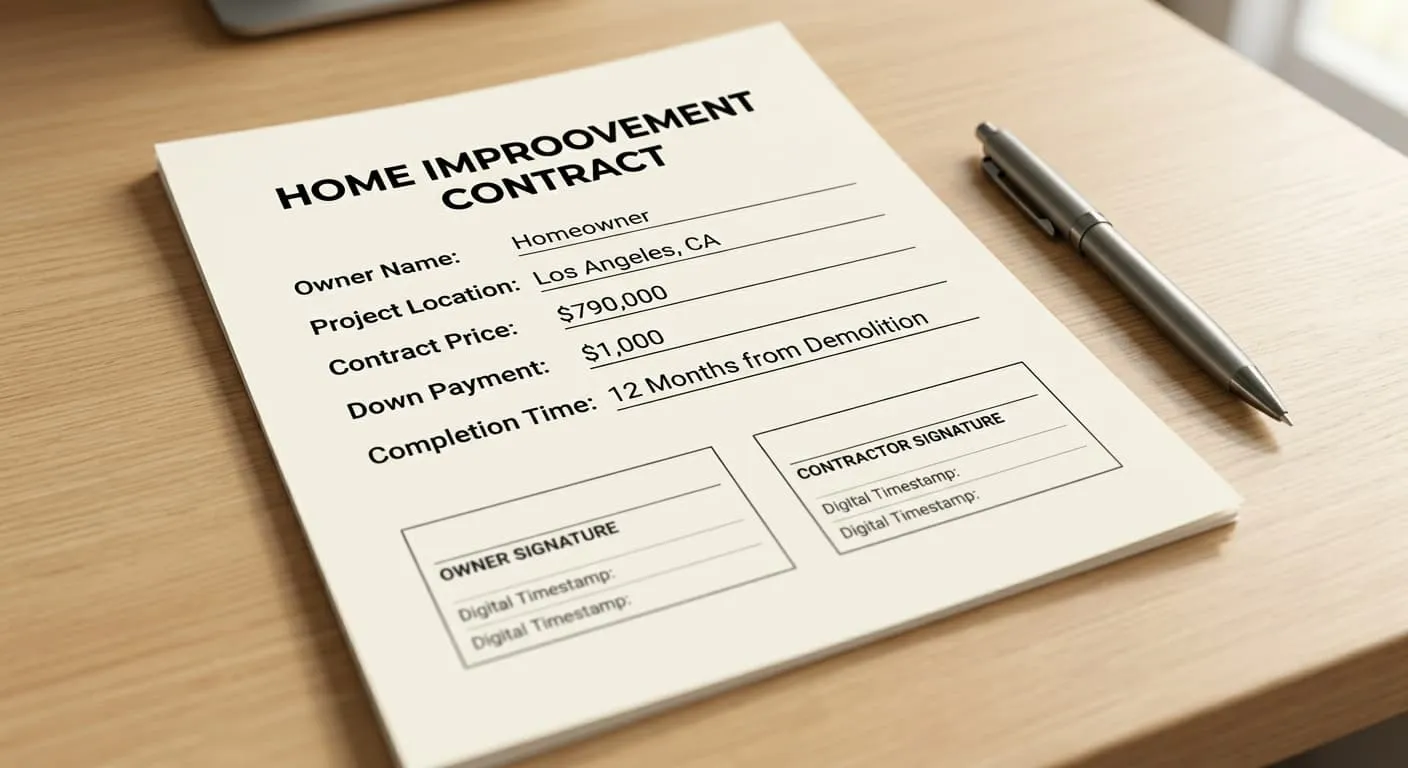

Cover page of our executed Home Improvement Contract showing the $790,000 contract value, $1,000 deposit, and 12-month completion timeline

Milestone-Based Payments: Protecting Your Capital

One of the most common pitfalls in residential remodeling is “front-loading” the contract—paying the contractor more money upfront than the actual value of work completed on site. If a builder falls behind schedule, goes out of business, or abandons the project, the homeowner is left with an unfinished house and little financial recourse.

To prevent this, we structured our payment schedule into 24 distinct, milestone-based progress payments.

By utilizing this milestone framework, we ensured that at no point during the 12-month build were we financially exposed. If work paused on site, our payments paused accordingly.

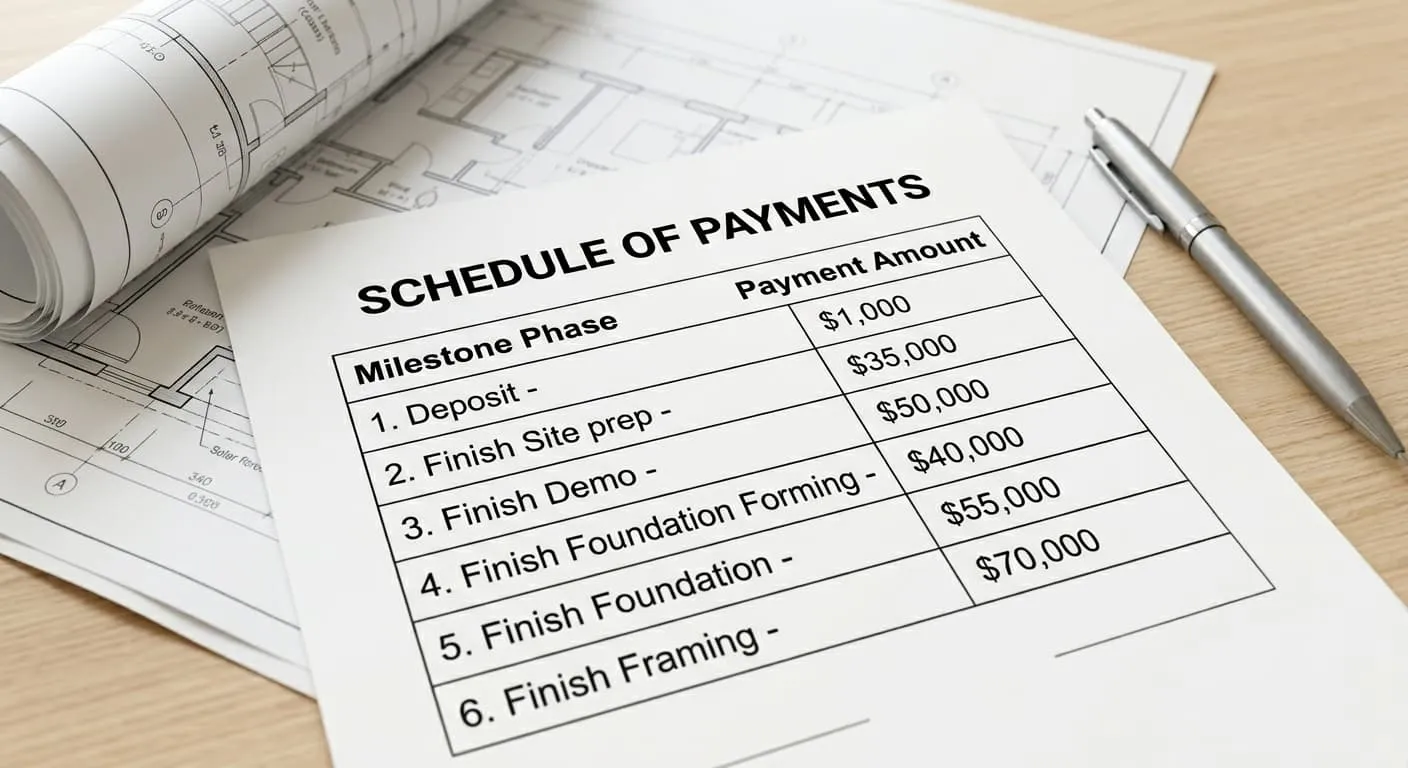

Schedule of payments table from the construction contract showing 6 milestone phases from the $1,000 deposit through $70,000 for finished framing

Managing Project Delays: The Rent Reimbursement Clause

A major home remodel and second-story addition typically requires the homeowners to move out and find temporary housing. For a projected 12-month build, that means 12 months of renting elsewhere. If the project drags on for 15 or 18 months, those extra rent payments can quickly deplete your contingency reserves.

To align our builder’s timeline with our own, we negotiated a specific delay penalty clause:

This clause acted as a financial incentive, keeping the general contractor focused on managing their crews and scheduling subcontractors efficiently to avoid delays.

Contract page showing the highlighted Delay & Rent Reimbursement clause requiring the company to pay $5,000 per month after 12 months from demolition

Strengthening Post-Completion Warranties

Most standard construction contracts offer a basic, state-mandated one-year warranty on workmanship. We negotiated several extended warranties to protect our home long-term:

  1. Extended Workmanship Warranty: We negotiated our builder’s standard one-year warranty on all workmanship, materials, and mechanical systems up to two years.
  2. Long-Term Bathroom Waterproofing: Because a major portion of our budget was dedicated to bathrooms (including a wet-room layout in the master bath), we secured a 10-year warranty for bathroom waterproofing.
  3. The Handyman Maintenance Clause: To help with ongoing home maintenance, our builder included a clause providing 7 individual days (8 hours each) of handyman services to be used at our discretion within 7 years of project completion.

Crucial Homeowner Call-Outs: What to Watch For

If you are currently reviewing a contract for your upcoming remodel, here are two critical legal details to negotiate:

  1. Tie Payments to “Completed and Verified” Work: Ensure your contract states that progress payments are due only after the specified milestone has been fully completed and verified by the homeowner or an independent inspector. Never accept arbitrary calendar dates (e.g., “Pay $50,000 on June 1st”), which force you to make payments even if the project is delayed.
  2. Explicitly Define Delay Exclusions: If you include a delay penalty or rent reimbursement clause, make sure it clearly defines what constitutes an excusable delay. Contractors should not be penalized for slow city inspections or backordered materials you chose late, but they should be held accountable for general management delays, crew scheduling issues, or failing to schedule inspections on time.
